Automated the fire safety installation workflow from site survey to customer quotation

Automated the fire safety installation workflow from site survey to customer quotation

Automated the fire safety installation workflow from site survey to customer quotation

Fire Suppression Design Center replaces a fragmented, Excel-based handoff between site contractors, installation engineers, and sales teams with one connected workflow platform. .

Role

Lead UI UX Designer

Scope

0 to 1 - Web/Tablet - B2B

Timeline

6 months

3-5

days to

1

day

Faster quotation time

12%

to

6%

Reduction in material estimate

75.6%

to

94.9%

Material calculaton acuuracy

12%

to

6%

Reduction in material estimate

Summary

What is product workflow and what I did

What is product workflow and what I did

The Product

Fire Suppression Design Center

Fire Suppression Design Center replaces a fragmented, Excel-based handoff between site contractors, installation engineers, and sales teams with one connected workflow platform.

Scope

Automated Centralized Platform

A platform that enables site contractor to upload structured Excel measurement data and automatically receive engineering calculations (pipe lengths, sensor counts, suppression agent, volumes) alongside a client-ready quote.

My Role

As lead product designer, I ran end-to-end discovery with all three roles - auditing real site-survey sheets, shadowing contractors on-site, and interviewing engineers and sales staff - to design FSDC.


Delivered role-based workflow platform built on one shared data-set instead of three disconnected files.

Result

Reduced quote generation time from 3-5 days to under 1 hour. Eliminated manual calculation errors. Standardized site survey data collection across 150+ site contractors. Improved quote accuracy by 85% in pilot testing..

Situation

One building, Three disconnected spreadsheets

Fire safety installation runs through three roles in sequence - site contractor, installation engineer, and marketing. Every handoff between them happens through a re-typed, reformatted Excel file, with no shared source of truth and no way to track where a project actually stands.

Site Contractor

Capture room, floor and load data

Installation Engineer

Room grouping, material quantity calculations & generate BOM

Sales Team

Face the client with Quotation

3 Roles

3 Spreadsheets

0 Shared Source of Truth

The existing workflow with all three users

Paper notes, later re-typed into Excel

2-3 hrs spend to reformatting data

Repetitive call/emails to confirm quantity

Agreement

Site Survey

  • Contractor gathers building details

  • Verify floor plans

  • Identify fire risks

Grouping & Calculation

  • Engineer make calculation & generate quotation

  • Make grouping of rooms

  • Make calculation & identify needed equipments

  • Generate quotation

Proposal & Pricing

  • Marketing team create the proposal based on quotation

  • Convert equipement list to BOM

  • Calculate labour material price

  • Add discounts

  • Review pricing

Agreement

  • Sales team deal with client with proposal

  • Present / send proposal to client

  • Handle objections & negotiations

  • Sign agreement

Every handoff is a chance to loose data

Task

How we can improve workflow efficiency

How we can improve workflow efficiency

Speed

Capture room, floor and load data

Accuracy

Capture room, floor and load data

Single Platform

Capture room, floor and load data

Success metrics defined with the PM

  • Site-visit-to-quotation time (baseline: 5-10 days), Target ~1 day.

  • Material estimation and calculation errors caught post-installation (baseline: ~25%), Target ~5%.

  • Site contractor data submission ~3 hrs, Target ~15 min

  • Engineer adoption rate at 45-60 days post-launch

Action

  • Discovery

Emphatise with users

Process Review

  • analogous calculation reviewed for grouping & estimation patterns

  • Gather qualitative and quantitative data

Process Review

  • analogous calculation reviewed for grouping & estimation patterns

  • Gather qualitative and quantitative data

User interviews

12 structured stakeholder interviews were conducted across all 3 roles

  • 5 site contractors

  • 5 Installation Engineer

  • 2 Sales Managers

Interviews explored pain points, workarounds, and wishes.

User interviews

12 structured stakeholder interviews were conducted across all 3 roles

  • 5 site contractors

  • 5 Installation Engineer

  • 2 Sales Managers

Interviews explored pain points, workarounds, and wishes.

Audited site-survey

spreadsheets

  • 20 real site-survey sheets audited

Audited site-survey

spreadsheets

  • 20 real site-survey sheets audited

What we observed and key learnings

Re-entry was the biggest time sink

Engineers spent 40–90 min per project just reformatting contractor sheets before real work began.

“Grouping” lived only in engineers' heads

Rooms were grouped by floor and fire-zone mentally, with no tool support for that step at all.

Marketing had zero visibility until the end

Client conversations couldn't start until the full material sheet landed in their inbox.

From the research, five critical insights emerged:

Insight 1 - Measurement data existed in at least 2-3 different formats across the site team. There was no standard template for what to measure or how to record it.

Insight 2 - Site contractors were using notepad and paper template to collect the site measurements.

Insight 3 - Knowledge Is Not Documented. Calculation logic existed in inconsistent Excel formulas.

Insight 5 - Sharing measurement data and check status of projects to others is the real struggle.

Insight 4 - Speed Is a Competitive Weapon: Customers repeatedly mentioned that the first credible quote received usually wins the contract. Turnaround time was directly correlated to win rate.

  • Define

Three roles - one shared job

Jerry Helfer

Site Contractor

I need to capture accurate data quickly, so the installation engineer doesn't come back with questions.

Goal: Finish site work and submit data quickly so he can get to the next site.

Stephanie Nicol

Installation Engineer

I need to add all received excel data into system and group rooms to calculate material confidently.

Goal: Receive clean, complete data and produce accurate material estimates without back-and-forth.

Kathy Pacheco

Sales Manager

I need a ready quotation fast, so I don't lose the deal to a slower competitor.

Goal: Close deals faster with accurate, competitive quotes that arrive before the client talks to a competitor.

User Journey Mapping of Site Contractor

Contractor visit the site

Does

Verify the building floor plan. rooms measurements, no. of floors & rooftop load capacity

Think

Get it right in 1st time

Doesn't have much information about project/client

Search client/site to capture data

Confident

Measurements of rooms

Does

Take the measurements of rooms floor wise on papers

Think

Written data should be clear

No structured place to log data on the spot

Captured data digitally as it’s measured

Focused

Create a spreadsheet

Does

Back to office and create spreadsheet with client's information and enter all the measurements in sheet

Think

Loosing time due to repetitive work

Data rentry increases the risk of transcription errors

Don't want data entry again

Concentrating

Send to installation engineer

Does

Review once, save the spreadsheet and send it to the installation engineer via email

Think

Did I capture everything needed?

No confirmation that all data has captured

Completion checklist + all data captured

Relieved

Frame the right problem statement

How might we enable Johnson Controls site contractors to capture and submit building measurement data in a standardized, mobile/tablet-friendly way so that accurate fire suppression material estimates and customer quotes can be generated automatically after uploading data in system without any manual engineering calculation?

Supporting How Might We statements:

HMW make it impossible for engineers to submit incomplete or ambiguous measurement data?

HMW help estimators spend their expertise on exceptions and quality-checking rather than routine calculation?

HMW give sales managers real-time visibility into quote pipeline status?

HMW ensure the system can handle vastly different building types - a single-story factory, a 20-floor residential tower, a hospital with ICU and OT zones?

HMW make the system usable on-site with limited connectivity?

Applied Design Principles

Design Principle

01

Match real-world mental model

Real terminology used: Rooms, Systems, Pipes, Sensors, Fitting etc

Design Principle

02

Error Prevention

Predefined Excel template uses header locks, dropdowns and number ranges. Portal validates file structure with specific instructions.

Design Principle

03

Progressive Disclosure

Initial high level summary. Detailed material breakdowns on one click and downloadable in required format.

Design Principle

04

Feedback & Transparency

Status indicators for every step. Alerts and email notifications for completion.

Design Principle

05

Consistency & Standard

Used design system to assure the consistency across the platform. Output quote matches Johnson Control’s brand guidelines precisely.

Design Principle

06

Accessibility

Portal meets WCAG 2.1 standards. Font sizes minimum 14px. Keyboard navigation supported.

  • Ideate

Design workshop with stakeholders

  • The ideation stage brought together a cross-functional team of product manager, business analyst, developers, site contractors, installation engineers, and sales managers.

  • Three design workshops were held over 5 days to get the simple solution.

Panel 1 of 5

Exploring Solutions

Align int

Align int

Align internal team on Room Grouping feature

Align internal team on Room Grouping feature

Panel 1 of 5

Exploring Solutions

Align int

Align int

Align internal team on Room Grouping feature

Align internal team on Room Grouping feature

Grouping of rooms in system

  • inspired by Kanban and Trello

Information Architecture

Information Architecture

Login

My Projects

Shared Projects

Import

Support

Notification

Support

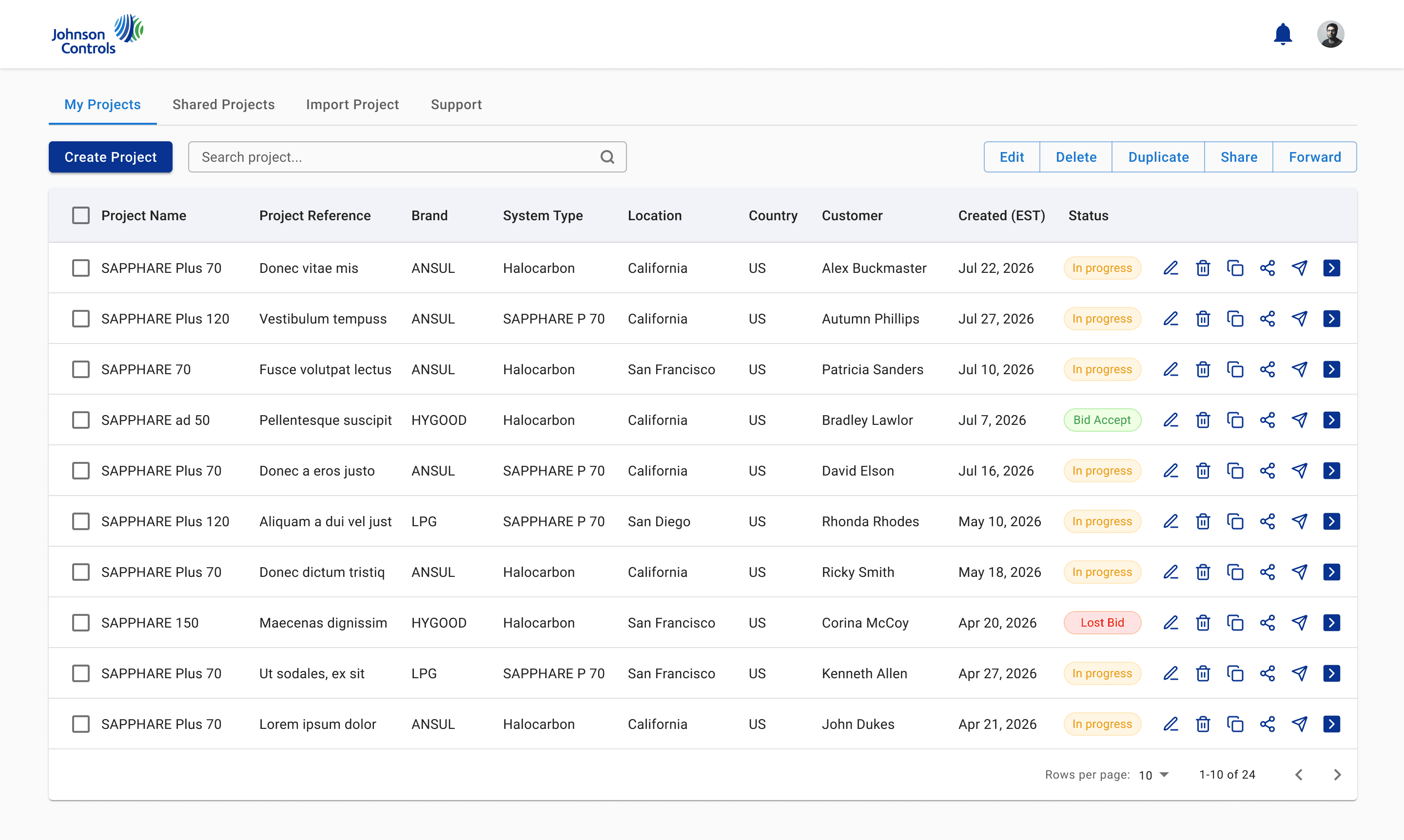

Project list

Search

filter

create new project

System details

hazard mgmt

Manifold

actuation

Nozzle & vents

bOM

send to sales

Dashboard

Authentication

View

Edit

Share

Assign

forward

RUN

  • Design

Wireframes - Rough Sketches

High-Fidelity Interface Design

High-Fidelity Interface Design

A digital centralised platfom includes:

A digital centralised platfom includes:

  • Validate

Test and Iterate

Testing was conducted in three phases:

  • Internal usability testing

  • Controlled pilot with real project, and

  • Phased production rollout with feedback loops built in.

Issues found & fixed

Load capacity field missed

Sat below the fold on tablet, moved into primary flow, marked required.

Engineers distrusted auto-calculation

Added an expandable “how this was calculated” breakdown per line item.

No filtering for marketing

Added region + status filters

Impact

Measured against the baseline before FSDC launched

Measured against the baseline before FSDC launched

Reduction in post-installation material errors

12% - 4%

12% - 4%

Faster site-visit-to-quotation time

3-5 days to

~1 day

3-5 days to

~1 day

Faster material estimation

or calculation accuracy

75.6% - 94.9%

75.6% - 94.9%

Engineer adoption rate

60 days

60 days

Thankyou
